Infrastructure Update – Week of October 05, 2026

0

There’s always infrastructure stories in the most densely-populated region of the country. Here’s what happened…

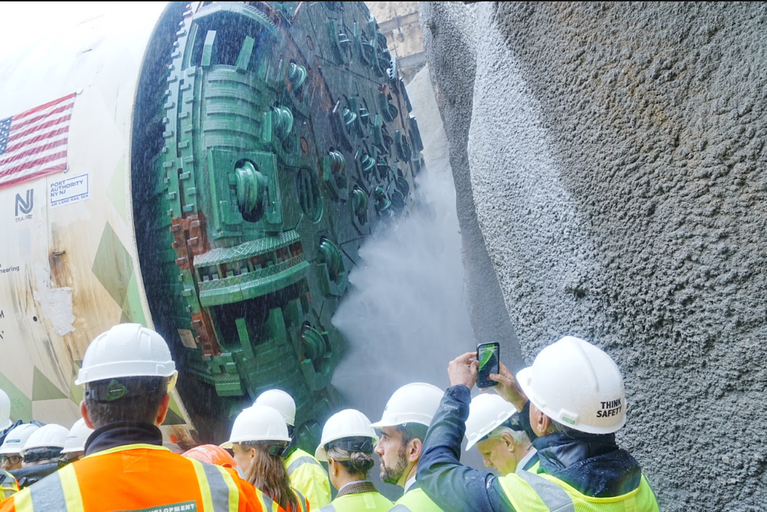

Hudson Tunnel Project reaches major boring milestone

The Gateway Program’s Hudson Tunnel Project has begun its most visible phase yet: tunnel boring beneath the Palisades. The first of two massive tunnel‑boring machines is now advancing roughly 30 feet per day, carving the initial 5,100‑foot segment toward the Hudson County Access Shaft. A second machine will follow shortly, with additional TBMs later deployed to excavate the section beneath the Hudson River. Officials say the new tunnel—expected to open in 2035—will double rail capacity, reduce delays, and generate tens of thousands of jobs.

Read more: https://tristateinfrastructurenews.com/can-you-dig-it-hudson-tunnel-reaches-boring-milestone/

AI data centers reshape northeastern Pennsylvania’s workforce

AI‑driven data‑center development is transforming job prospects in northeastern Pennsylvania, reviving former industrial sites and creating new high‑skill opportunities. While developers tout thousands of potential jobs, experts warn that workforce gaps—especially in skilled trades—could limit the region’s ability to fully benefit. Local leaders emphasize the need for training programs, community engagement, and careful planning to ensure the economic gains are widely shared.

Read more: https://www.pennlive.com/opinion/2026/09/ais-data-centers-are-rebuilding-careers-in-northeastern-pennsylvania-opinion.html

Pallone Urges FERC to Strengthen Oversite of PJM on Data Centers

New Jersey Congressman Frank Pallone has asked the Federal Energy Commission (FERC) to use its authority with grid operator PJM’s proposals on handling data centers. Pallone who serves as the Ranking Member of the Energy and Commerce Committee wrote to FERC Chairman Laura Swett regarding PJM’s proposed framework to connect data centers and urged FERC to use its authority to help protect customers. PJM has proposed requiring data centers to pay for new power plants to bring their own generating capacity on-line. Data centers have become a focus point in mid-term elections. Pallone has been outspoken on the need to have federal guardrails in place.

Read more: www.roi-nj.com/2026/09/29/industry/energy-utilities/pallone-urges-ferc-to-shield-pjm-customers-with-strong-rules-for-data-centers/

PJM Delays Auction Following FERC Decision

Grid operator PJM decided to delay its planned backstop procurement auction for data centers after the Federal Energy Regulatory Commission (FERC) decided to approve it only partially. FERC said parts of PJM’s plans were unjust and unreasonable, and it was filed late and did not give the agency enough time to offer corrections. PJM was going to accept offers for backstop procurement from the end of September through October 21 and select offers from October 22 through December 2, announcing them before holding its standard capacity auction.

Read more: www.utilitydive.com/news/pjm-delays-backstop-procurement-ferc-data-center

Electric school buses expand across New York

New York districts are accelerating the shift to electric school buses, though progress remains uneven. The state currently operates 559 electric buses out of roughly 45,000, and recent policy changes have extended the deadline for full fleet conversion to 2040. Districts adopting early models report significantly lower fuel costs and smoother operations, but the scale of statewide transition remains daunting, requiring more than 3,000 conversions per year to meet the mandate.

Read more: https://www.nytimes.com/2026/09/23/nyregion/electric-school-buses.html

Hurricane season remains unusually quiet

This year’s Atlantic hurricane season has been notably subdued, with forecasters observing fewer named storms and lower overall activity than average. Experts attribute the slowdown to emerging El Niño conditions, which typically suppress storm formation, though warmer ocean temperatures complicate predictions. Meteorologists caution that even in below‑normal seasons, a single storm can still cause major damage, urging coastal residents to maintain preparedness.

Read more: https://www.usnews.com/news/national-news/articles/2026-09-25/whats-going-on-with-this-years-hurricane-season

Europe faces intensifying climate extremes

Record‑breaking heat continues to sweep across Europe, with France and the UK experiencing their hottest temperatures ever recorded for June. Meteorologists warn that extreme heat events once considered rare are becoming the “new normal,” driven by rapid climate change. The heatwave has triggered wildfires, evacuations, and widespread disruptions across multiple countries, underscoring the growing urgency of climate adaptation.

Read more: https://www.bbc.com/news/articles/crq5x16w09z3o

Portal North Bridge enters final phase of construction

The century-old Portal Bridge is nearing retirement as Amtrak and NJ TRANSIT prepare to transfer the final track of rail service to the new Portal North Bridge over the Hackensack River.

TLDR
1. Amtrak and NJ TRANSIT will begin transferring the final track to the new Portal North Bridge on Oct. 9; regular schedules are expected to return Nov. 15, subject to safety testing.
2. Every NJ TRANSIT rail line except the Atlantic City Rail Line will have temporary schedule changes, including weekday Midtown Direct diversions to Hoboken.
3. The new fixed bridge will retire the 116-year-old swing bridge and eliminate a persistent source of Northeast Corridor delays; demolition of the old structure is scheduled for 2027.

Cutover work on the Portal North Bridge is scheduled to begin October 9 and will require approximately five weeks of temporary schedule changes across nearly the entire NJ TRANSIT rail system. If the work and safety testing remain on schedule, regular service is expected to resume November 15 with all trains traveling over the new bridge.

The transition will mark the end of passenger service on the 116-year-old Portal Bridge, a movable swing bridge that has long been a source of delays for trains traveling between New Jersey and New York. The replacement is one of the first major pieces of the broader Gateway Program to enter service.

Five weeks of schedule changes

Temporary NJ TRANSIT schedules will take effect Sunday, October 11. Every rail line except the Atlantic City Rail Line will experience some combination of changed departure times, altered stopping patterns, train consolidations or cancellations.

The largest changes will affect weekday Midtown Direct service. Trains on the Morris & Essex Lines, Gladstone Branch and Montclair-Boonton Line will be diverted to Hoboken rather than operating directly to New York Penn Station. Riders will be able to continue to Midtown using enhanced NY Waterway ferry service, the No. 126 bus or PATH; cross-honoring will be available under the temporary service plan.

Weekend Midtown Direct trains will continue operating to and from New York Penn Station. Raritan Valley Line one-seat rides to and from New York will end at Newark Penn Station throughout the cutover period.

NJ TRANSIT and Amtrak said the schedule was designed to maintain service on every rail line while providing enough access for crews to safely transfer the bridge’s rail, electrical and communications systems. Riders are being advised to review the temporary timetable for their line and allow additional travel time.

Additional work planned during service reductions

The agencies are using the reduced train traffic to complete other maintenance projects that would otherwise require separate disruptions.

On the North Jersey Coast Line, work on the movable bridge at Brielle will replace rail service with buses between Bay Head and Manasquan for two weeks beginning Oct. 11. On the Port Jervis Line, eight weekday midday trains will be replaced by buses between Suffern and Port Jervis from Oct. 11 through Nov. 14. Buses will also replace Raritan Valley Line trains between Cranford and Newark on Nov. 7 while Conrail replaces track.

Amtrak plans to complete eight additional maintenance projects across the Northeast Corridor in six states and Washington, D.C., during the same reduced-service period.

Replacing a persistent Northeast Corridor bottleneck

The original Portal Bridge opened in 1910 and must rotate open to allow boats to pass along the Hackensack River. Its age and movable design have made it a recurring point of failure on the Northeast Corridor; when the bridge does not properly lock back into position after an opening, trains cannot cross until crews resolve the problem.

The new Portal North Bridge is a two-track, high-level fixed span with 50 feet of clearance above the river, twice the clearance of the old bridge. Marine traffic will be able to pass beneath it without stopping trains.

One track on the new bridge entered passenger service March 16 following the first cutover earlier this year. The second cutover will move the remaining trains off the old bridge and place both tracks of the new structure into full operation.

The immediate benefit is reliability. Removing the movable bridge eliminates one of the corridor’s best-known mechanical failure points and reduces conflicts between rail and river traffic. The new structure is also designed for faster train speeds and greater operational resilience.

The Gateway Program’s longer-term plan calls for a future Portal South Bridge beside it; together, the two bridges would carry four tracks and match planned capacity improvements between Newark and New York.

A $1.56 billion construction contract

The Portal North Bridge project covers 2.44 miles of the Northeast Corridor and includes retaining walls, deep foundations, concrete piers, structural steel spans and new rail systems. NJ TRANSIT awarded the approximately $1.56 billion construction contract to the Skanska/Traylor Bros PNB Joint Venture in 2021, making it the largest construction award in the agency’s history at the time.

The project is funded primarily by the U.S. Department of Transportation, New Jersey and Amtrak. A federal Full Funding Grant Agreement provided $766.5 million toward construction.

The new bridge is built from approximately 23,000 tons of steel and 219,000 cubic yards of concrete. Construction also required more than 35 miles of pipe piles, over three miles of drilled shafts and nearly a mile of retaining walls.

After the final track enters service, work will continue around the corridor and on removal of the old structure. Dismantling of the original Portal Bridge is scheduled for 2027. For riders, the final cutover will mean several weeks of inconvenience before one of the Northeast Corridor’s oldest and least reliable structures leaves service permanently.

Sources:

Amtrak. (2026, March 12). NJ TRANSIT and Amtrak prepare to open first track on new Portal North Bridge. https://media.amtrak.com/2026/03/nj-transit-and-amtrak-prepare-to-open-first-track-on-new-portal-north-bridge/

Amtrak. (2026, September 17). Portal North Bridge enters final phase of construction as work begins to put final track into service. https://media.amtrak.com/2026/09/portal-north-bridge-enters-final-phase-of-construction-as-work-begins-to-put-final-track-into-service/

Gateway Development Commission. (n.d.). The Gateway Program. https://www.gatewayprogram.org/aboutgateway.html

NJ TRANSIT. (2026, September 17). Portal North Bridge enters final phase of construction as work begins to put final track into service. https://www.njtransit.com/press-releases/portal-north-bridge-enters-final-phase-construction-work-begins-put-final-track

Who oversees New York’s infrastructure?

0

The agencies/authorities responsible for New York’s physical and digital infrastructure

New York’s trains, airports, roads, bridges, electrical grid, drinking and wastewater, and digital infrastructure is managed, protected, and administered by a host of state, regional and federal agencies and authorities.

Unlike a traditional state department, a public authority is generally created for a specific public purpose and governed by a board. New York relies heavily on these entities to operate toll roads, transit systems, bridges, power facilities and other major assets. The state’s Authorities Budget Office monitors their compliance with reporting, governance and transparency requirements.

NYDOT New York State Department of Transportation


State highways, bridges, roads, freight and passenger rail policy, aviation, ports and waterways, public transportation assistance, traffic operations, construction and transportation resilience

MTA Metropolitan Transportation Authority


New York City subways and buses, Long Island Rail Road, Metro-North Railroad, seven bridges and two tunnels, stations, accessibility, service reliability and major transit capital projects

New York State Thruway Authority


The 570-mile Thruway system, including I-87, I-90 and the Governor Mario M. Cuomo Bridge; toll collection, maintenance, safety and highway capital projects

NYSBA New York State Bridge Authority


The Bear Mountain, Newburgh-Beacon, Mid-Hudson, Kingston-Rhinecliff and Rip Van Winkle bridges across the Hudson River; tolls, maintenance and bridge capital projects

DMV New York State Department of Motor Vehicles


Driver licensing, vehicle registration, traffic-safety administration, inspection programs and motor-vehicle regulation

New York State Canal Corporation


The Erie, Champlain, Oswego and Cayuga-Seneca canals; locks, dams, navigation, trails, water management and canal infrastructure. The corporation is a subsidiary of the New York Power Authority

DEC Department of Environmental Conservation


Air and water quality, wastewater and stormwater permits, wetlands, dams, contaminated sites, solid waste, flood protection, coastal resources, climate policy and environmental enforcement

New York State Department of Health


Drinking-water standards, public water-system oversight, source-water protection, operator requirements and public-health response to contamination

EFC Environmental Facilities Corporation


Low-cost financing and grants for drinking-water, wastewater, sewer, stormwater, resiliency and other water-quality projects through the state revolving funds and state grant programs

PSC Public Service Commission and DPS Department of Public Service


Regulation and oversight of electric, gas, steam, telecommunications, cable and privately owned water utilities; utility rates, reliability, consumer protection and major energy infrastructure proceedings

NYPA New York Power Authority


State-owned power generation and transmission, hydropower, grid modernization, energy services, public-sector electrification and operation of the Canal Corporation

NYSERDA New York State Energy Research and Development Authority


Clean-energy programs, building efficiency, renewable energy, energy storage, grid research, offshore wind, emissions reduction and financing or incentives for energy projects

ORES Office of Renewable Energy Siting and Electric Transmission


Consolidated environmental review and permitting for major renewable-energy facilities and qualifying electric-transmission projects

HCR New York State Homes and Community Renewal


Affordable-housing development and preservation, housing finance, community renewal, disaster recovery, resilient housing and infrastructure connected to housing growth

ESD Empire State Development


Economic-development incentives, site preparation, redevelopment, infrastructure supporting business expansion, major public projects and regional investment programs

DASNY Dormitory Authority of the State of New York


Financing, design and construction services for health care, higher education, courts, nonprofits and other public-purpose facilities

Hudson River Valley Greenway



The Hudson River Valley Greenway coordinates trail development, public access and community planning. It provides planning grants and assistance to participating municipalities.

New York State Office of General Services


State-owned buildings, design and construction, emergency construction, real estate, facility operations, public procurement and decarbonization of state facilities

NYSED New York State Education Department


Review of public-school capital projects, school building standards, facilities planning and health and safety requirements for school infrastructure

Office of Information Technology Services


State government networks, data centers, digital services, telecommunications, technology infrastructure and cybersecurity for state agencies

DHSES Division of Homeland Security and Emergency Services


Emergency management, disaster response and recovery, hazard mitigation, interoperable communications, cybersecurity assistance and protection of critical infrastructure

NYDOL New York State Department of Labor


Infrastructure workforce programs, apprenticeships, prevailing-wage enforcement and labor standards on public works

Department of Agriculture and Markets

Farmland protection, agricultural land use, food-system infrastructure and regulation affecting renewable-energy development on agricultural land

PANYNJ Port Authority of New York and New Jersey

JFK, LaGuardia, Newark Liberty, New York Stewart and Teterboro airports; PATH; interstate bridges and tunnels; the Port Authority Bus Terminal; ports and marine terminals

NYMTC New York Metropolitan Transportation Council


Federally required transportation planning and funding coordination for New York City, Long Island and the lower Hudson Valley; long-range planning, congestion management, freight and air-quality compliance

DRBC Delaware River Basin Commission


Interstate planning, regulation and management of water resources in the Delaware River Basin, including portions of southeastern New York

U.S. Army Corps of Engineers New York District


Federal navigation projects, harbor maintenance, dredging, coastal storm-risk reduction, flood mitigation, wetlands permitting and major water infrastructure

FEMA Federal Emergency Management Agency Region 2


Disaster declarations, recovery assistance, hazard-mitigation grants, flood mapping and resilience programs in New York

US EPA U.S. Environmental Protection Agency Region 2


Superfund sites, drinking water, wastewater, air quality, environmental review, federal grants and enforcement of federal environmental laws in New York

PJM framework could help data centers connect without raising regional power costs

The regional grid operator wants large electricity users to supply their own power or become the first customers curtailed during an emergency.

TLDR:
1. PJM is proposing new rules that could require data centers and other large electricity users to reduce demand before homes and traditional customers are affected during a grid emergency.
2. Data centers account for 30 gigawatts, or nearly 94%, of PJM’s projected electricity-demand growth between 2024 and 2030.
3. FERC must approve the framework before it can take effect.

PJM Interconnection has proposed a new framework that would allow data centers and other large electricity users to connect to the regional power grid without forcing existing customers to absorb the full cost or reliability risk created by their demand.

Under the proposal, new large energy users that do not bring enough additional power generation to support their operations could be required to reduce their electricity consumption before homes and other traditional customers are affected during a grid emergency. The framework would apply across PJM’s 13-state territory, which includes New Jersey, Pennsylvania and parts of the Mid-Atlantic and Midwest.

The proposal arrives as electricity demand from data centers is growing much faster than new generating capacity can be built. PJM expects demand across its territory to grow by approximately 32 gigawatts between 2024 and 2030; data centers account for 30 gigawatts, or nearly 94%, of that projected increase.

One gigawatt is roughly enough electricity to serve hundreds of thousands of homes, although the exact number varies depending on weather, consumption patterns and the type of generation involved.

“The unprecedented addition of large loads, most notably data centers, has given rise to resource adequacy shortfalls and associated real-time operational issues,” PJM said in its filing.

What is IRAS?

The centerpiece of the proposal is a new program called the Interim Resource Adequacy Service, or IRAS. It would cover new large customers that have not secured enough additional generation to meet their expected demand and whose needs are not addressed through another PJM reliability procurement program. PJM defines a large load as one or more facilities with a combined peak demand of at least 50 megawatts.

When available electricity supplies begin approaching dangerously low levels, PJM could direct utilities to reduce or transfer demand associated with these new large customers. Data centers equipped with backup generation could temporarily disconnect from the grid and operate using those on-site systems.

The reduction would occur before PJM moved toward shutting off traditional customers, including residential users. It would also come before certain customers that are already paid through demand-response programs to reduce electricity consumption during emergencies.

A large customer ordered to reduce its demand could receive a credit for providing a reliability service. States and utilities would determine how those credits and other retail costs are allocated; companies could also waive compensation to prevent the costs from being passed to other customers.

The Large Load Registry

PJM would also establish a Large Load Registry covering new and existing facilities across its territory. The database would track information including each facility’s size, location, expected opening date and available backup generation.

PJM would make the information available to states, utilities and regulators, subject to confidentiality restrictions. The registry is intended to improve demand forecasts and help officials determine which facilities should reduce their consumption during an emergency.

States would retain authority over retail electric rates and local curtailment plans. PJM would determine how much demand must be removed from the regional system; state regulators and utilities would decide which eligible customers would be affected and how related costs would be distributed.

Bring, build or buy

The proposal follows a broader principle that new data centers would be expected to construct new generation, arrange for additional power supplies or purchase electricity from resources that expand the overall supply available to the grid. This is known as the  “build, bring or buy” model. PJM would require utilities and other electricity suppliers to secure new capacity equal to or greater than the combined peak demand of new large customers in their service territories. If they fail to do so, those areas could be directed to reduce demand during emergencies based on their share of unsupported large-load growth.

PJM is also proposing a significant change to its capacity market, which pays power plants to remain available several years into the future. Beginning with the 2029-2030 capacity auction, new large customers that have not supplied their own additional generation would be excluded from PJM’s calculation of the power that must be purchased through the auction. The provision is intended to prevent unsupported data center demand from increasing capacity costs for all customers. It also creates an incentive for developers to secure new power supplies before connecting to the grid.

New Jersey is moving in the same direction

PJM’s proposal closely aligns with data center policies recently adopted in New Jersey. Legislation signed by Gov. Mikie Sherrill in July requires large data centers to bring additional clean energy onto the grid and creates a separate electric rate classification for the industry. The goal is to prevent the cost of serving energy-intensive developments from being distributed across residential and small-business customers.

New Jersey followed that action in August with a law requiring data center operators to submit semiannual reports to the Board of Public Utilities detailing their electricity and water consumption. The reports must include information about total energy use, energy used for cooling and computing equipment, peak water demand and on-site or backup generation.

The state reporting requirement and PJM’s proposed registry address different levels of the same problem. New Jersey’s system would provide state regulators and communities with more information about individual facilities; PJM’s registry would help the regional grid operator track their combined effect on electricity demand and reliability.

FERC final steps

PJM filed the proposal with the Federal Energy Regulatory Commission on Aug. 13 and requested approval within 60 days. Until FERC acts, the framework remains a proposal and could be approved, rejected or modified.

The plan would not solve the region’s underlying shortage of new generation, but it would change the conditions under which new data centers connect to the system. Developers that arrive with enough additional power would receive conventional service; those that do not could face a higher risk of interruption and would no longer automatically add their full demand to capacity purchases funded by the wider customer base.

For New Jersey, the PJM framework could reinforce the state’s emerging position that data center development can continue, so long as their extraordinary electricity needs do not compromise reliability or increase costs for existing ratepayers.

Sources:

New Jersey Legislature. (2026). Senate Bill No. 731: Requires electric public utilities to develop and apply special rules for certain data centers to protect non-data center customers from increased costs. https://www.njleg.state.nj.us/bill-search/2026/S731

New Jersey Legislature. (2026). Senate Bill No. 3379: Requires reporting concerning energy and water use by data centers. https://www.njleg.state.nj.us/bill-search/2026/S3379

Office of Governor Mikie Sherrill. (2026, August 27). Governor Sherrill delivers all four pillars of data center plan, puts power back in the hands of communities. State of New Jersey. https://www.nj.gov/governor/news/2026/20260827a.shtml

PJM Interconnection. (2026, August 13). Interim Resource Adequacy Service proposal [Fact sheet]. https://www.pjm.com/-/media/DotCom/about-pjm/newsroom/fact-sheets/interim-resource-adequacy-service-proposal.pdf

PJM Interconnection. (2026, August 13). PJM proposes framework to connect data centers without compromising reliability, affordability. https://insidelines.pjm.com/pjm-proposes-framework-to-connect-data-centers-without-compromising-reliability-affordability/

Can You Dig it? Hudson Tunnel reaches boring milestone

As Gateway advances on several fronts, the Hudson Tunnel Project has reached its most visible construction milestone yet.

TLDR
1. Gateway marked the start of Hudson Tunnel boring on September 28.
2. The machines are expected to reach the Hudson County Access Shaft about a year after launch.
3. The entire Gateway program is moving forward on schedule.

Portal North Bridge is preparing to transfer its second track in October, while initial Sawtooth Bridges work and Dock Bridge rehabilitation are advancing.

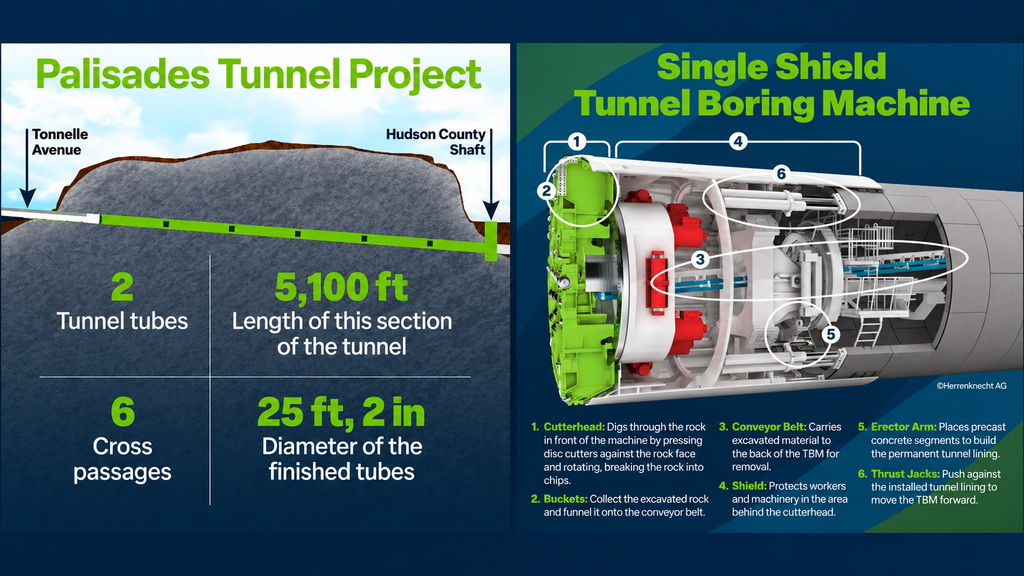

The first tunnel boring machine for the $16 billion Hudson Tunnel Project is undergoing final testing in North Bergen and is expected to begin digging in the coming days. The Gateway Development Commission marked the start of the boring phase at a September 28 ceremony and a second machine is expected to follow soon after. Together, they will excavate the first two tubes of a new rail connection between New Jersey and New York Penn Station.

The two machines are built for the hard rock beneath the Palisades. Each weighs more than 1,680 tons, roughly the weight of 300 elephants, with a cutterhead 28 feet, 8 inches in diameter and an equipment assembly stretching about 500 feet behind it. Rotating cutters break the rock into chips, a conveyor carries the material out, and the machine installs precast concrete segments to line the tunnel as it advances.

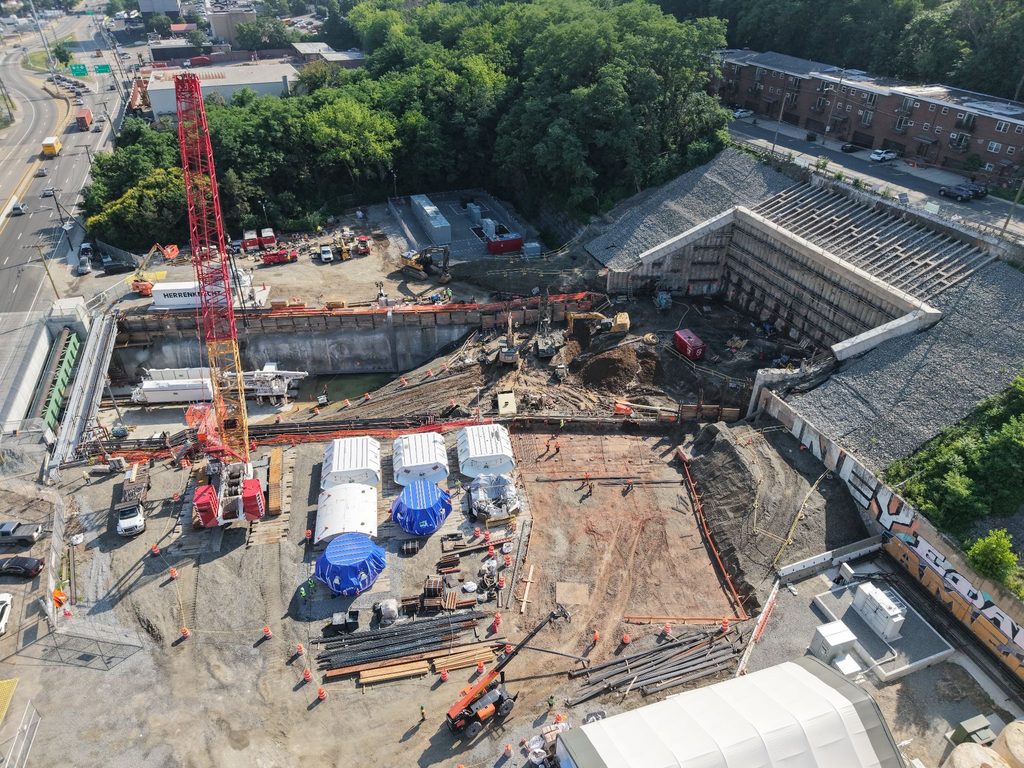

Courtesy of the Gateway Development Commission

Each machine will bore approximately 5,100 feet from the North Bergen portal to the Hudson County Access Shaft near the Weehawken–Hoboken border. Gateway expects progress of about 30 feet per day, including scheduled maintenance stops, and estimates that the machines will reach the shaft roughly one year after launch. They will then be removed and replaced with two machines suited to the changing rock and soil conditions beneath the Hudson River. Four boring machines, working in two pairs, are needed to complete the parallel tubes; the machines launching now will not dig the river section.

The launch follows nearly three years of construction. Since late 2023, crews have built a bridge carrying Tonnelle Avenue above the work area and excavated the launch box below it. Photo courtesy of the Gateway Development Commission.

Manufacturing each machine took more than a year and involved nearly 100 components; after factory testing in late 2025, the machines were taken apart, shipped to New Jersey and reassembled on site. The Palisades tunneling contract is being carried out by Schiavone Lane Dragados JV, with the Port Authority of New York and New Jersey managing its delivery in partnership with Gateway.

The light at both ends of the tunnel

The next pair of machines will build two tubes beneath the Hudson River, each approximately 7,250 feet long, from the Hudson County Access Shaft to Manhattan’s 12th Avenue Access Shaft. Gateway awarded the $1.29 billion contract for that section to Traylor/Walsh/Skanska JV in April. The work also includes nine passages connecting the two tubes, providing routes between them.

Other crews are building the approaches that will make the tunnel usable. In New Jersey, the surface alignment will connect the North Bergen portal to the existing Northeast Corridor near Secaucus across approximately 1.5 miles. Plans call for 4,170 feet of retaining walls, a 3,150-foot viaduct over Meadowlands wetlands, and bridges measuring 90 and 150 feet. Tracks, signals and other railroad systems will follow under a future construction package.

In Manhattan, construction includes the access shaft, work beneath West 30th Street, stabilization of the riverbed near the shoreline and the final section of concrete casing beneath Hudson Yards. That casing will preserve the route into New York Penn Station. Gateway describes the Hudson Tunnel Project as 10 construction packages; one was completed in early 2026 and six more are in progress.

“This milestone is a major step toward fulfilling the Hudson Tunnel Project’s two-track tunnel and giving New Jerseyans the dependable rail infrastructure they’ve waited decades for.” U.S. Senator Cory Booker said, “Millions of people depend on the Northeast Corridor every day to get to work, to school, and back home to their families. I’m proud to help deliver a project that will lower costs, strengthen our rail system, boost reliability, double capacity, and make commutes better for generations of New Jerseyans to come.”

The schedule calls for the new tunnel to open in 2035. Crews would then rehabilitate the existing North River Tunnel, which has carried trains since 1910 and was flooded during Hurricane Sandy; Gateway expects that work to finish in 2038. When both tunnels are available, Amtrak and NJ TRANSIT will have four tracks beneath the Hudson instead of two. That added flexibility matters on a crossing where trouble in one of the current tubes can disrupt trains in both directions.

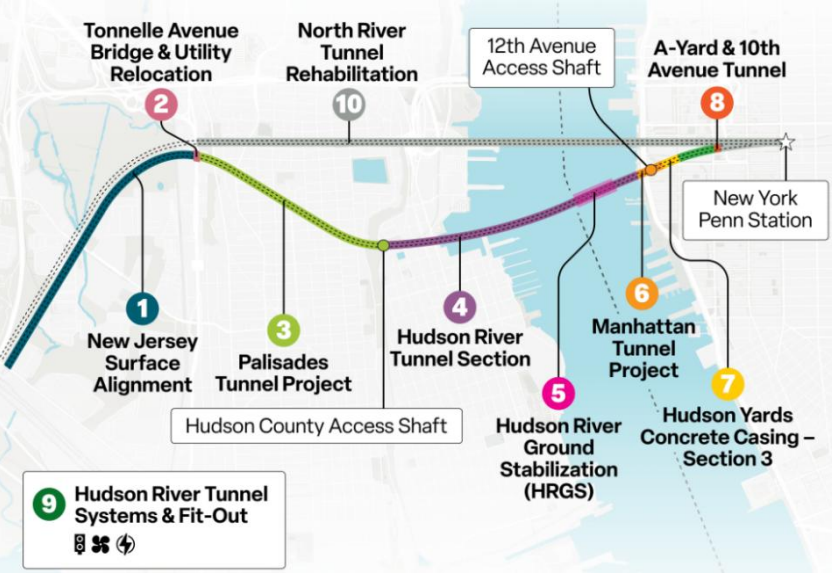

Where the larger Gateway Program stands

Courtesy of the Gateway Development Commission

Gateway covers the roughly 10-mile Northeast Corridor segment between Newark and New York Penn Station. Approximately 450 trains carry 200,000 passenger trips through it each day, according to the program. At rush hour, trains move through the corridor in close succession, while drivers face heavy traffic on the New Jersey Turnpike and the approaches to the Lincoln and Holland tunnels. The pressure on both rail and road travel makes clear the importance of adding capacity in this pinch point.

Portal North Bridge, another key piece of the Gateway program, also hit a milestone this month. Its first track entered passenger service in March. Amtrak and NJ TRANSIT plan to begin transferring the second track from the 116-year-old movable Portal Bridge on October 9, with approximately five weeks of adjusted service beginning October 11. Regular schedules are expected to resume November 15, subject to safety testing. The replacement is a fixed, two-track bridge rising about 50 feet above the Hackensack River, allowing boats to pass without requiring trains to stop for a bridge opening.

Farther west, Amtrak and NJ TRANSIT are moving ahead with initial construction for the Sawtooth Bridges replacement, backed by a $133 million federal grant for preparatory work. Amtrak has applied for additional funding for later construction. In July, it awarded contracts for a roughly $242 million rehabilitation of Dock Bridge over the Passaic River, where major work is expected to begin by the end of 2026. Longer-term Gateway plans include a second bridge over the Hackensack, additional tracks near Harrison and Secaucus, and expanded capacity at New York Penn Station.

Sources:

Gateway Development Commission. (2026, September 28). Gateway Development Commission celebrates start of tunnel boring for Hudson Tunnel Project

New Jersey Infrastructure Bank: 40 years helping communities fund local infrastructure

0

TLDR
1. The New Jersey Infrastructure Bank (I-Bank) provides low-cost financing for critical public works projects.
2. By blending federal grants and state funds with AAA-rated bonds, it offers below-market interest rates, saving local taxpayers and ratepayers billions of dollars.
3. While it successfully funds water, transportation, and resilience upgrades, it faces challenges from surging project demand, inflation, and complex regulatory mandates.

Aging infrastructure poses one of the most persistent financial and operational hurdles for local governments and utility authorities. In New Jersey, this challenge is met by the New Jersey Infrastructure Bank (NJIB)—widely known simply as the I-Bank. Operating as an independent state financing authority, the I-Bank provides and administers low-interest and subsidized loans to municipalities, counties, regional authorities, and water purveyors. Its overarching mission is to finance vital public works projects while shielding local property taxpayers and utility ratepayers from the crushing financial burden of traditional, high-interest municipal bonding.

Founding and history

The origins of the I-Bank date back to the mid-1980s, a period when New Jersey faced mounting federal mandates to clean up its waterways and upgrade aging municipal wastewater systems.

  • Establishment: The authority was created by an act of the New Jersey State Legislature under the New Jersey Infrastructure Trust Act, being signed into law in 1985 by Governor Thomas H. Kean.
  • Operations Launch: The I-Bank officially commenced operations in 1986, initially rolling out its pioneering clean water financing division.
  • Evolution of Scope: Over the decades, the I-Bank’s mandate expanded significantly beyond wastewater. Today, it operates three specialized divisions in partnership with state agencies: the NJ Water Bank (in partnership with the NJ Department of Environmental Protection), the NJ Transportation Bank (with the NJ Department of Transportation), and the NJ Resilience Infrastructure Bank (with the NJ Office of Emergency Management).

How it works and loan rates

The brilliance of the I-Bank model lies in its ability to leverage public capital to achieve below-market borrowing costs that small towns and regional utilities could never secure independently.

  • The Blended Financing Model: Instead of relying strictly on commercial capital markets, the I-Bank pools local borrowing needs and combines federal capitalization grants (from programs like the EPA and FEMA) with state contributions. It then issues AAA-rated revenue bonds.
  • Interest Rate Structure: Loans are typically structured as a blended package. Borrowers receive a mix of state-funded capital—frequently at a 0% interest rate—combined with market-rate financing from the I-Bank’s bond sales.
  • The Cost-Savings Result: This unique blend reduces overall borrowing costs by roughly 25% to 40% compared to traditional standalone municipal bond issues, translating to substantial lifetime savings for local communities.

Overall impact since inception

Since its creation four decades ago, the I-Bank has served as the backbone of New Jersey’s capital investment in public infrastructure, achieving remarkable milestones:

  • Billions in Financing: Through its flagship Water Bank alone, the program has issued over $9.28 billion in low-interest long-term loans, alongside billions more in short-term construction financing.
  • Direct Ratepayer Savings: New Jersey ratepayers and taxpayers have saved over $3.43 billion in reduced interest costs and principal forgiveness awards.
  • Widespread Reach: The I-Bank has issued more than 1,480 long-term loans, touching virtually all 21 counties and supporting hundreds of towns, municipal utilities, and regional authorities.
  • Job Creation: Cumulative loan spending has generated an estimated 180,730 direct construction jobs across the state, boosting local economic activity while modernizing critical networks.

2025 project examples

Demand for I-Bank financing remains exceptionally high, with recent fiscal years drawing thousands of project applications. A cross-section of projects advancing through the I-Bank illustrates its diverse reach:

  • Passaic Valley Sewerage Commission (PVSC): Secured an $183 million loan to construct a state-of-the-art standby power generating facility, guaranteeing uninterrupted backup electricity for regional wastewater treatment operations.
  • Stafford Township: Closed on a $5 million loan for continuing wastewater and stormwater infrastructure upgrades to replace aging sewer mains.
  • Brick Township Municipal Utilities Authority: Utilized a $9.27 million joint Water Bank and Resilience Bank loan (paired with federal grants) to harden critical reservoir infrastructure against severe storms.
  • Hoboken: Advanced major multi-modal safety projects, including the Sinatra Drive Redesign ($5.35 million) through the Transportation Bank framework.

Challenges looking forward

Despite its immense success, the I-Bank navigates a complex array of modern challenges:

  • Unmet Capital Demand: Statewide infrastructure needs—particularly for replacing lead service lines, removing PFAS “forever chemicals,” and upgrading century-old water mains—vastly exceed annual funding capacity, with total needs estimated well over $31 billion.
  • Administrative Barriers: Smaller, disadvantaged municipalities often lack the specialized engineering and grant-writing personnel required to navigate complex federal and state compliance rules, risking resource disparities.
  • Emerging Environmental Mandates: Balancing traditional repairs with modern climate resilience, storm-hardening, and emerging contaminant filtration places continuous bandwidth pressure on the authority.

Sources:

New Jersey Department of Environmental Protection. (2026). New Jersey environmental infrastructure financing program: State Fiscal Year 2027 financing program. State of New Jersey. https://dspace.njstatelib.org/bitstreams/aa8a8dea-23bd-483d-bcc4-f476099ec839/download

New Jersey Infrastructure Bank. (2023). New Jersey Infrastructure Bank annual report: State Fiscal Year 2022 appendix. State of New Jersey. https://nj.gov/njoem/mitigation/pdf/2023/Appendix%20A1%20Annual%20Report%202022.pdf

New Jersey Infrastructure Bank. (n.d.). About NJWB. State of New Jersey. https://www.njib.gov/nj/about-njeit

New Jersey Infrastructure Bank. (n.d.). About us. State of New Jersey. https://www.njib.gov/nj/about-us

Infrastructure Update – Week of September 28, 2026

0

New Jersey and New York saw major developments this week across data‑center regulation, water infrastructure, grid reliability, emissions policy, and battery‑storage planning, reshaping regional energy priorities.

Water industry groups praise overwhelming House passage of WRDA

Water‑sector organizations are celebrating the House’s 415–9 passage of the Water Resources Development Act, which authorizes major investments in flood control, navigation, ecosystem restoration, and water‑infrastructure upgrades. The bill strengthens Army Corps project delivery and expands support for communities facing aging systems and climate‑driven flooding. Groups say the vote reflects rare bipartisan consensus on water resilience.

Read more: https://www.enr.com/articles/63686-water-industry-groups-praise-overwhelming-415-9-house-passage-of-wrda-bill

Newark office complex activates 14‑megawatt on‑site substation

A Newark office building along McCarter Highway has brought a 14‑megawatt on‑site substation online, providing tenants with enhanced reliability and reducing strain on the surrounding grid. The privately funded project supports energy‑intensive commercial operations and future redevelopment, reflecting a broader trend of large facilities investing in dedicated power infrastructure as data‑center growth increases grid pressure.

Read more: https://www.roi-nj.com/2026/09/22/industry/energy-utilities/on-site-14-megawatt-power-substation-now-online-at-mccarter-highway-office-building-in-newark/

New York acknowledges Indian Point closure increased emissions

New York State has formally stated that closing the Indian Point nuclear plant raised statewide carbon emissions, confirming long‑standing warnings from grid analysts. Gas‑fired generation increased to fill the gap, complicating the state’s climate‑mandate compliance and raising questions about future nuclear retirements. The acknowledgment arrives amid debates over how to balance reliability, affordability, and decarbonization.

Read more: https://yonkerstimes.com/new-york-state-now-says-in-writing-that-closing-indian-point-raised-emissions/

Opinion: permitting delays are driving up electric bills

A RealClearEnergy analysis argues that permitting bottlenecks – not generation shortages – are a major driver of rising U.S. electric bills. Long interconnection queues, slow environmental reviews, and transmission‑siting challenges delay new clean‑energy projects and force reliance on older, costlier fossil‑fuel plants. The piece contends that permitting reform is essential to lowering long‑term rates and accelerating renewable deployment.

Read more: https://www.realclearenergy.org/articles/2026/09/22/your_electric_bill_is_a_permitting_problem_1207409.html

New data centers projected to reduce residential electricity rates

A new analysis suggests that upcoming data‑center projects could lower residential electric bills under New Jersey’s emerging regulatory framework. The state now requires data centers to fund their own generation, storage, or grid upgrades, preventing costs from being shifted onto households. Analysts say this private investment could stabilize rates and reduce grid congestion.

Read more: https://tristateinfrastructurenews.com/new-data-centers-projected-to-reduce-residential-electricity-rates/

Op‑ed calls for major expansion of battery‑storage construction

A BINJE op‑ed argues that New Jersey must dramatically expand battery‑energy‑storage construction to meet reliability and clean‑energy goals. The author calls for faster permitting, clearer interconnection rules, and incentives for both utility‑scale and distributed storage. With data‑center growth and electrification increasing grid volatility, the piece frames storage as essential infrastructure.

Read more: https://binje.com/uncategorized/op-ed-what-we-need-to-build-battery-energy-storage/

New Jersey fines DataOne $1.07M for unpermitted generators

New Jersey issued $1.07 million in fines to DataOne after inspectors found 62 natural‑gas generators installed and operated without air‑quality permits. Regulators say the company bypassed preconstruction and operating approvals required under the Air Pollution Control Act, marking the largest enforcement action ever taken against a data center in the state. The case underscores rising scrutiny of data‑center emissions, noise, and grid impacts as the sector expands rapidly.

Read more: https://www.yahoo.com/news/us/articles/jersey-fines-dataone-1-07-173211365.html

New Jersey storm resource directory

0

Track power outages across New Jersey and find utility contacts, cooling centers and emergency resources during severe weather.

Report a Power Outage

PSE&G

Jersey Central Power & Light

Atlantic City Electric

Customers served by a municipal electric department should report outages directly to their municipality. The outage numbers above match the utilities’ storm-reporting information; some general state directories list separate customer-service numbers. (NJOEM utility directory)

Downed Power Lines

Treat every downed wire as live and dangerous. Stay at least 30 feet away; do not touch the wire or anything it may be contacting. Call 911 and notify the appropriate electric utility.

If a power line falls on a vehicle, remain inside unless the vehicle is on fire or another immediate danger requires evacuation.

During an Outage

  • Use flashlights instead of candles whenever possible.
  • Keep refrigerator and freezer doors closed.
  • Never operate a generator, grill or fuel-burning appliance indoors or inside a garage.
  • Place generators outdoors, at least 20 feet from doors, windows and vents.
  • Do not use a gas oven or stove to heat a home.
  • Call 911 if someone is experiencing a medical emergency.
  • Call NJ 2-1-1 for information about warming or cooling centers, shelters and other non-emergency assistance.

Additional Resources

New Jersey Built a Perfect Light Rail, and Nobody Noticed [Classy Whale]

0

The Hudson-Bergen Light Rail is one of the country’s most successful light rail systems, but it rarely receives national attention. Learn more about how it has transformed transportation along the waterfront.
